The cutover is rehearsed before it is real

Whether it is a first build or a move off something you have outgrown, the risky part is never the installation. It is the sequence, the timing and the reconciliation — so those are the parts we run twice.

See it live

The rehearsal, staged the same way as the cutover

Model, provision, connect and prove — each phase timed during rehearsal so the live window has a measured duration rather than an estimate.

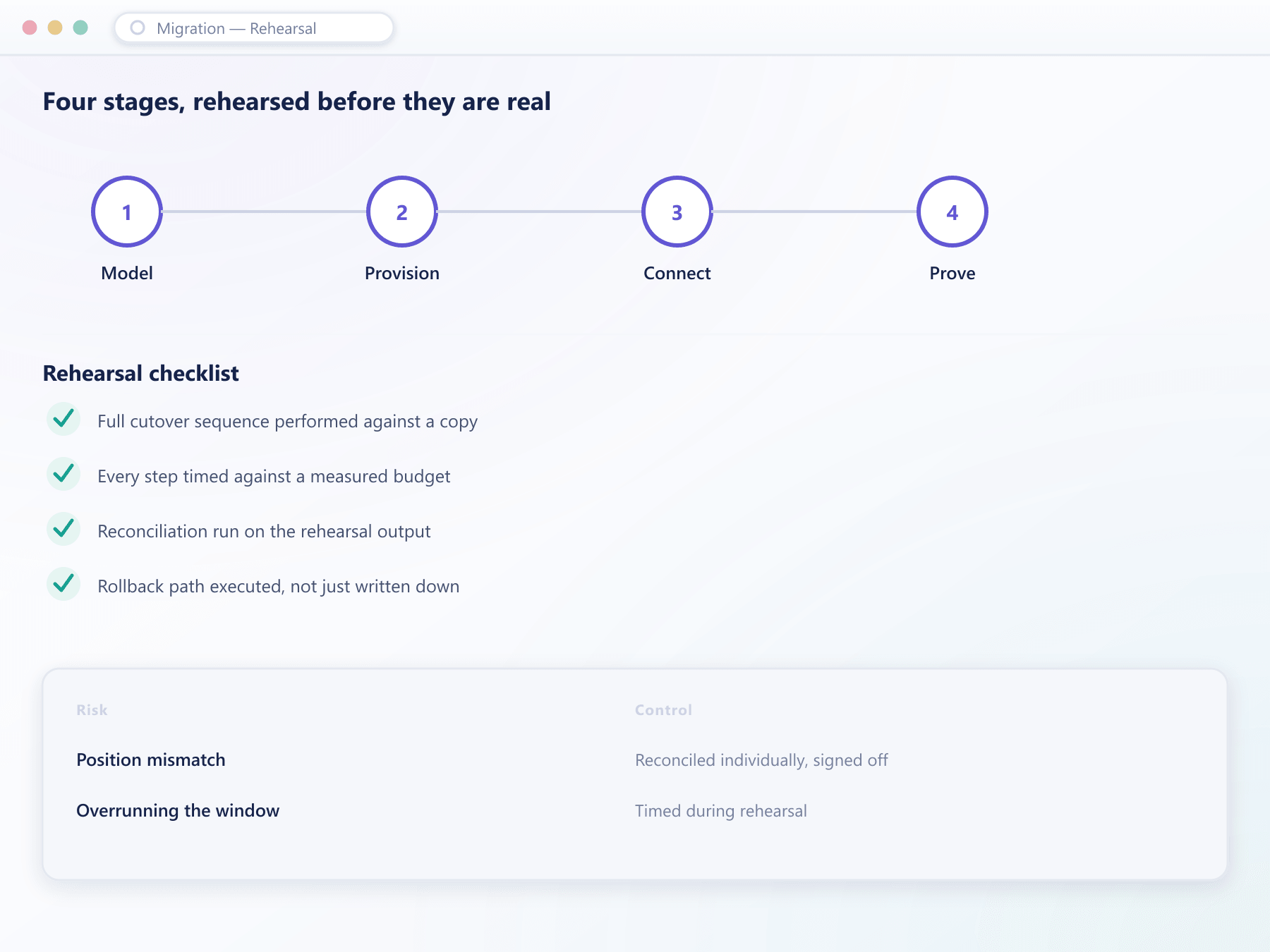

Four-stage migration sequence with a rehearsal checklist and risk controls

A new build

Four stages, and the first one has nothing to do with software

01

Model

Decide the structure before installing anything

How instruments group, how client segments differ, which providers serve which flow. These decisions are expensive to reverse later and cost nothing to get right at the start.

02

Provision

Build the environment on the right ground

Servers placed for proximity to your providers, sized for your expected load, with the standby topology in place from day one rather than added after the first outage.

03

Connect

Bring up providers one at a time

Each connection is certified and observed on its own before it contributes to a client-facing price, so a misbehaving feed is identified in isolation instead of in aggregate.

04

Prove

Trade it before anyone else does

Orders are placed through every path — each instrument group, each client segment, each destination — and the resulting positions, margin and statements are checked against expectation.

Migration risk

Six things that go wrong, and what stops each one

RiskControl
Position mismatch

Every open position reconciled individually and signed off before clients reconnect

Balance discrepancy

Ledgers compared on both sides; differences investigated rather than adjusted away

Symbol specification drift

Contract sizes and precision compared instrument by instrument against the source

Silent client lockout

Credential reset communicated ahead of the window with a tested recovery path

Overrunning the window

Full sequence timed during rehearsal so the window has a measured duration

No way back

Source environment left intact and reachable until reconciliation is signed off

The rehearsal

The night itself should be boring

A cutover that has been performed once already, end to end, is an execution task. One that has only been planned is an experiment with your clients’ positions.

  • The full cutover sequence performed against a copy, start to finish

  • Every step timed, so the live window has a duration rather than a hope

  • Reconciliation run on the rehearsal output and checked line by line

  • The rollback path executed too, not just written down

  • A named owner assigned to each step before the live run

FAQ

Setup and migration: common questions

6 short answers to what teams ask before a demo.

The build itself is usually days once provider credentials and instrument requirements are settled. What extends a project is almost never the installation — it is third-party approvals and decisions about how the book should be structured.

Skipping the rehearsal. Every step in a cutover is individually straightforward; what goes wrong is the sequence, the timing and the reconciliation, and none of those can be verified from a written plan alone.

Usually a credential reset, communicated ahead of the window with a recovery path that has been tested. Everything else should be invisible to them, and if it is not, the migration was not rehearsed properly.

Yes. The source environment stays intact and reachable until reconciliation on the target has been signed off. The rollback path is executed during the rehearsal, so it is a proven route rather than a paragraph in a plan.

It is carried across where the target platform supports it. Where it does not, history is archived in a queryable form so client statements and any regulatory request can still be answered.

Often, yes — by client segment or by instrument group. Both environments run under the same change control and connect to the same providers during the transition, so behaviour stays consistent while the move happens.

Still have a question?

A specialist will answer it directly, with your set-up in mind.

Ask a specialist
Plan it properly

Bring us the move you have been putting off

We will tell you what it involves, what it risks and how long the window needs to be — before anyone commits to a date.

Call us+971 52 654 0123WhatsApp+971 52 654 0123Email usinfo@multiprimex.com
Book a demo
